Gentari Australia reaches mechanical completion at 243MWp solar-plus-storage project

Facebook
Twitter
LinkedIn
Reddit
Email

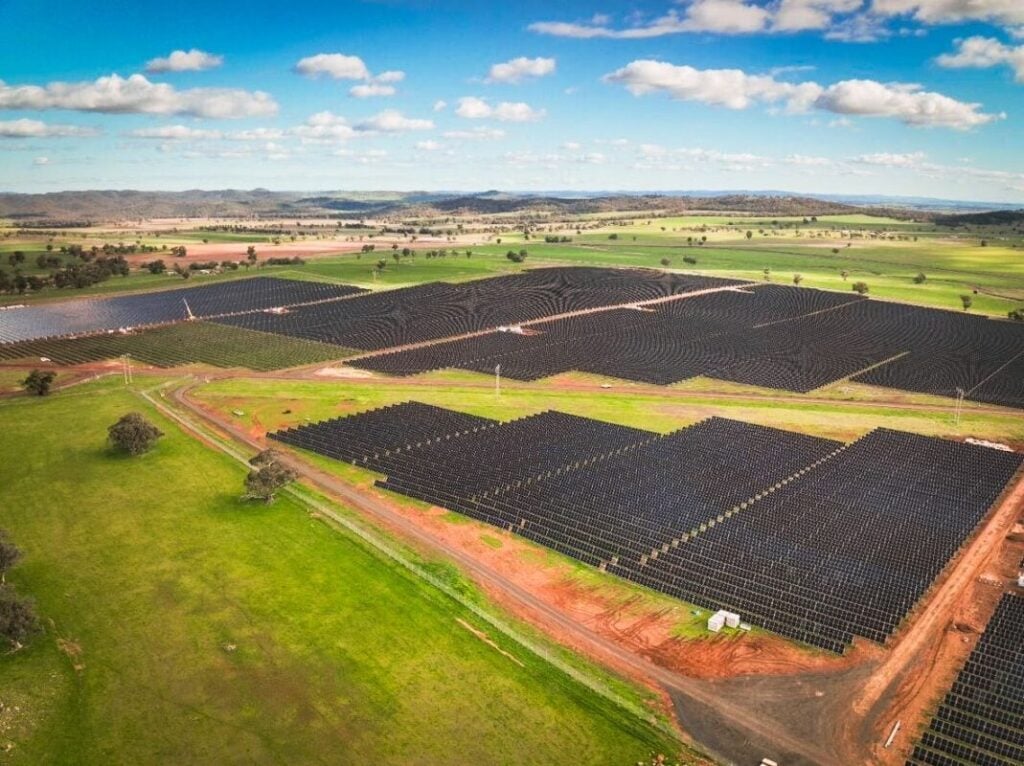

The project (pictured) incorporates a 172MW/409MWh lithium iron phosphate (LFP) battery energy storage system (BESS) in a DC-coupled configuration. Image: Gentari Australia.

Gentari Australia, the local subsidiary of Malaysian clean energy company Gentari Renewables, has reached mechanical completion at the 243MWp Maryvale Solar and Energy Storage Project near Dubbo in New South Wales.

The milestone marks the end of physical construction on the solar-plus-storage site, with commissioning and grid connection works now expected to follow ahead of commercial operations.

This article requires Premium SubscriptionBasic (FREE) Subscription

Try Premium for just $1

  • Full premium access for the first month at only $1
  • Converts to an annual rate after 30 days unless cancelled
  • Cancel anytime during the trial period

Premium Benefits

  • Expert industry analysis and interviews
  • Digital access to PV Tech Power journal
  • Exclusive event discounts

Or get the full Premium subscription right away

Or continue reading this article for free

The project integrates 243MWp of solar generation capacity with a 172MW/409MWh lithium iron phosphate (LFP) battery energy storage system (BESS) in a DC-coupled configuration, meaning the solar array connects directly to the battery at the DC level before conversion to AC for grid export.

This configuration offers several advantages over traditional AC-coupled systems, including improved efficiency, reduced equipment costs and enhanced flexibility in energy dispatch.

The facility’s maximum export capacity into the National Electricity Market (NEM) is 172MW. It can import up to 91MW.

PCL Construction served as the engineering, procurement and construction contractor. Gentari acknowledged PCL alongside a number of other partners in its announcement, including SOLMECH, Nextpower, Stralis Energy, All Energy Contracting, EPEC Group and Essential Energy.

TrinaSolar supplied the solar PV modules and CATL supplied the battery storage system. Spanish inverter manufacturer Ingeteam was selected as the project’s inverter supplier in a deal that marked the first DC-coupled solar-plus-storage project in eastern Australia to proceed to construction.

The tracker system was supplied by Canadian racking company Polar Racking, which secured the Maryvale contract as its first Australian project, in a deal that gave the company a foothold in the country’s rapidly expanding utility-scale solar market.

The project is located within the Central-West Orana Renewable Energy Zone, approximately 37km south-east of Dubbo on a 360-hectare site.

It holds a Long-Term Energy Service Agreement (LTESA) awarded through the fourth AEMO Services tender under the NSW Electricity Infrastructure Roadmap, making it one of the first solar-plus-storage projects to secure an LTESA under that framework.

From groundbreaking to mechanical completion

The project has moved through construction in just under a year. As PV Tech reported when Gentari broke ground in August 2025, the site was positioned as one of Australia’s first large-scale DC-coupled solar and storage projects, with commercial operations targeted for early 2027.

The Maryvale project originated with solar developer Wirsol Energy Australia before Gentari’s acquisition of that business in 2023.

The DC-coupled architecture at Maryvale allows solar energy that would otherwise be clipped during peak generation periods to be captured and stored in the battery, improving the overall efficiency of the system compared to AC-coupled configurations. It also reduces equipment costs and enhances flexibility in how power is dispatched to the grid.

Mechanical completion brings Gentari’s Australian clean energy portfolio to approximately 814MW across utility-scale solar farms and hybrid projects spanning New South Wales, Queensland and Victoria.

Commercial operations are scheduled for the second quarter of 2027.

Read Next

September 4, 2026
India's CEA has proposed mandatory grid-forming inverters and co-located energy storage for new renewable energy projects from July 2027.
September 4, 2026
Victoria's SEC has connected the 119MW solar PV plant component of its SEC Renewable Energy Park in Australia to the grid for the first time.
September 3, 2026
PVFARM launches RE PILOT platform to optimise utility-scale solar and co-located solar-plus-storage projects.
September 3, 2026
The UAE has raised its renewable and nuclear energy target to account for 35% of its energy mix by 2030-31, according to state-run media.
September 1, 2026
Canadian renewables development-stage developer Westbridge Renewable Energy has entered into a definitive share purchase agreement for the sale of its 225MWac Red Willow solar-plus-storage project in Canada.
September 1, 2026
Australia recorded its strongest quarter yet for rooftop solar installations, household battery storage uptake and large-scale solar investment in Q2 2026, according to the Clean Energy Regulator's (CER) latest Quarterly Carbon Market Report.

Upcoming Events

Solar Media Events
October 13, 2026
San Francisco Bay Area, USA
Solar Media Events
November 3, 2026
Málaga, Spain
Solar Media Events
November 24, 2026
Warsaw, Poland
Solar Media Events
February 2, 2027
London, UK
